QScope

Dayworks

Three percentages, not one

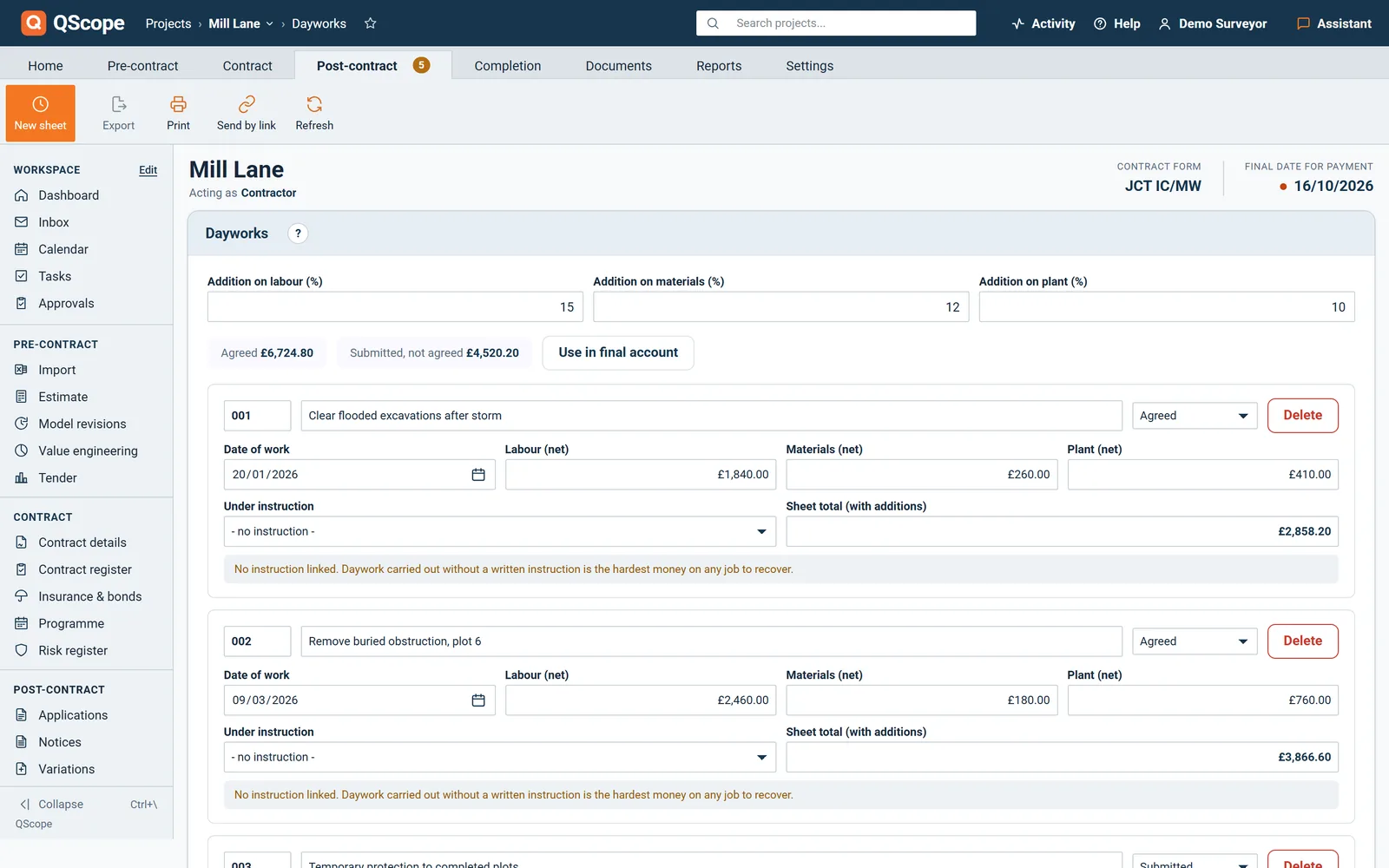

The contract states separate additions for labour, materials and plant. Applying an average to the lot is quick, and it is the reason the sheet comes back with a query instead of a signature.

  • Each sheet links to the instruction that authorised the work
  • Sheets with no instruction linked are flagged
  • Architect’s instruction, CVI and site instruction all recorded

30 days free, no card.

Instructions
Authority behind DW-014
TypeArchitect’s instruction
ReferenceAI-022
Date issued5 Aug 2026
Cost effectYes
Sheets against itDW-014

A daywork sheet with no instruction against it is flagged rather than quietly totalled, because unauthorised daywork is rarely recovered.

No instruction, no daywork

A daywork sheet with no instruction behind it is the hardest money on any job to recover.

The work was done, the hours are real, and without written authority it will be refused. The register exists so the authority is on file before the sheet is submitted. QScope links every sheet to the instruction that authorised the work, and flags any sheet that has none, in the same place the sheet is prepared.

Dayworks

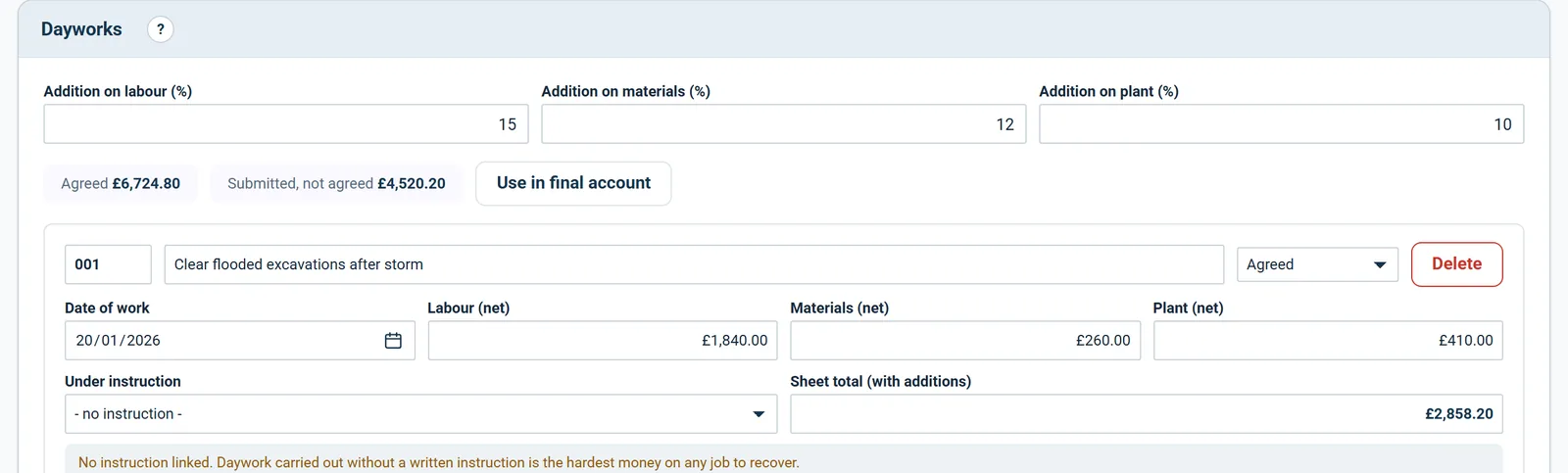

Each addition applied to its own element

The percentages differ because they cover different things.

  • Separate additions for labour, materials and plant
  • Sheet total shown with the percentages that produced it
  • Submitted, agreed, disputed and rejected held as separate states
Dayworks
Sheet DW-014
Labour £2,000 + 130%£4,600
Materials £3,000 + 15%£3,450
Plant £500 + 20%£600
Sheet total£8,650

A single blended addition of 55 per cent on the same sheet gives £8,525. Close enough to look right, far enough apart to be argued about.

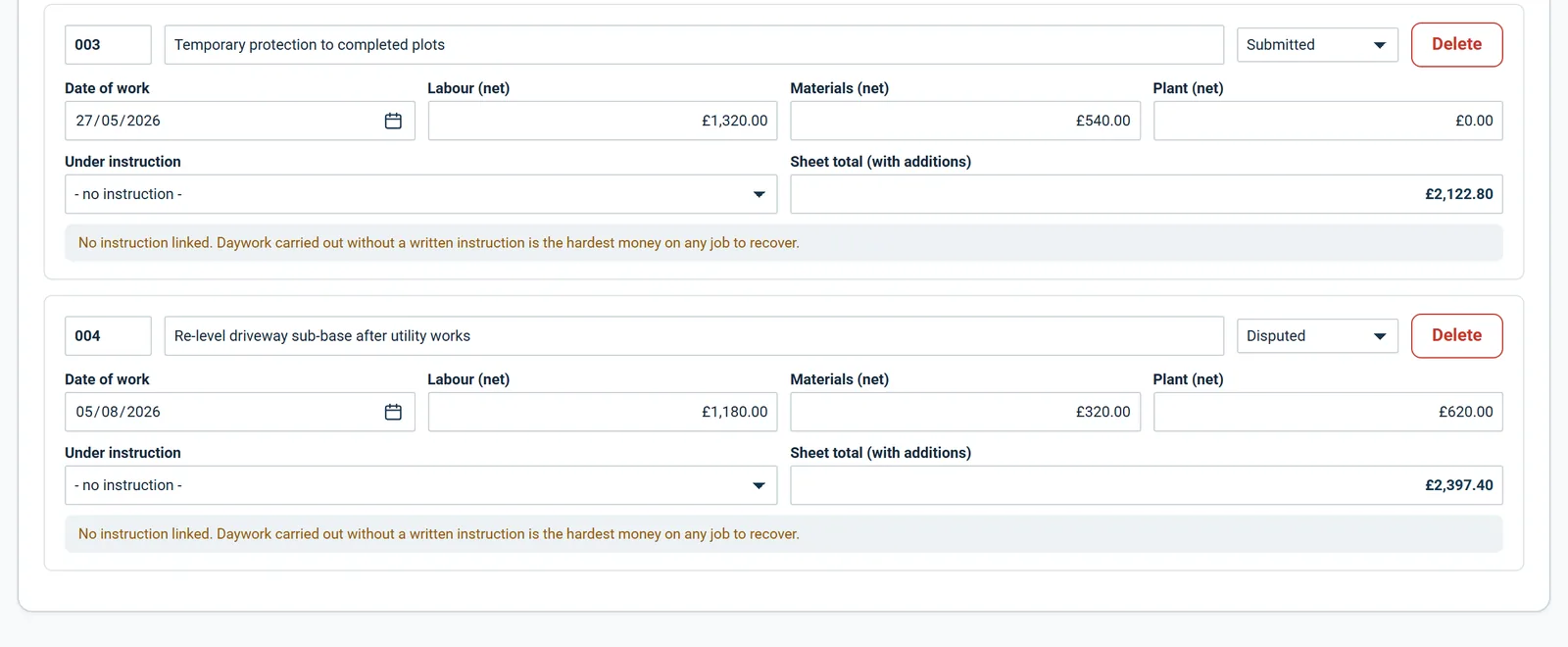

Dayworks

Agreed is not the same as submitted

Only sheets marked as agreed are carried into the final account.

  • Agreed total and submitted total shown separately
  • One click carries the agreed total to the dayworks line of the final account
  • Daywork Sheets print with the additions stated
Dayworks
Position
Agreed
£18,420
Submitted
£6,900
Sheets
14
Carried to final account£18,420
Awaiting agreement£6,900
Sheets without an instruction2

Daywork carried out without a written instruction is the hardest money on any job to recover, so those sheets are flagged rather than quietly totalled.
